Essential Plumbing and Electrical Considerations for Dental Office Renovations

Commercial interior rough-in showing dental office renovation plumbing and electrical systems


The dental office renovation plumbing and electrical scope is invisible in the finished photos, and it is also the part that decides whether the clinic runs smoothly for the next fifteen years. Every operatory needs water, suction, compressed air, drainage, and a dense web of power and data, all roughed in before a single wall closes. Our dental clinic build-out services live and die on getting these systems right the first time, because opening a wall after the practice is running is painful and expensive.

This guide explains how the mechanical and electrical layers of a dental fit-out actually work, what a good contractor coordinates behind the drywall, and where projects most often go wrong.

Why the Rough-In Phase Matters Most

A dental operatory is one of the most service-dense spaces in commercial construction. A single chair needs potable water, a drain, high- and low-volume suction, compressed air, nitrous lines in some clinics, plus power, network cabling, and often an intraoral or panoramic imaging feed. Multiply that by six or eight chairs, and you have a mechanical puzzle that has to be solved on paper before excavation of the slab even begins.

Get the rough-in right, and the finished clinic feels effortless. Get it wrong, and you are cutting into a new floor to move a drain. This is why an experienced fit-out team spends so much time on coordination drawings before demolition.

Did You Know?

Much of a dental clinic’s plumbing runs under the floor slab, not in the walls. That is why chair positions have to be final before the concrete is cut and poured. Moving an operatory by even half a metre after the slab is closed can mean breaking concrete and re-coring the drain and suction lines.

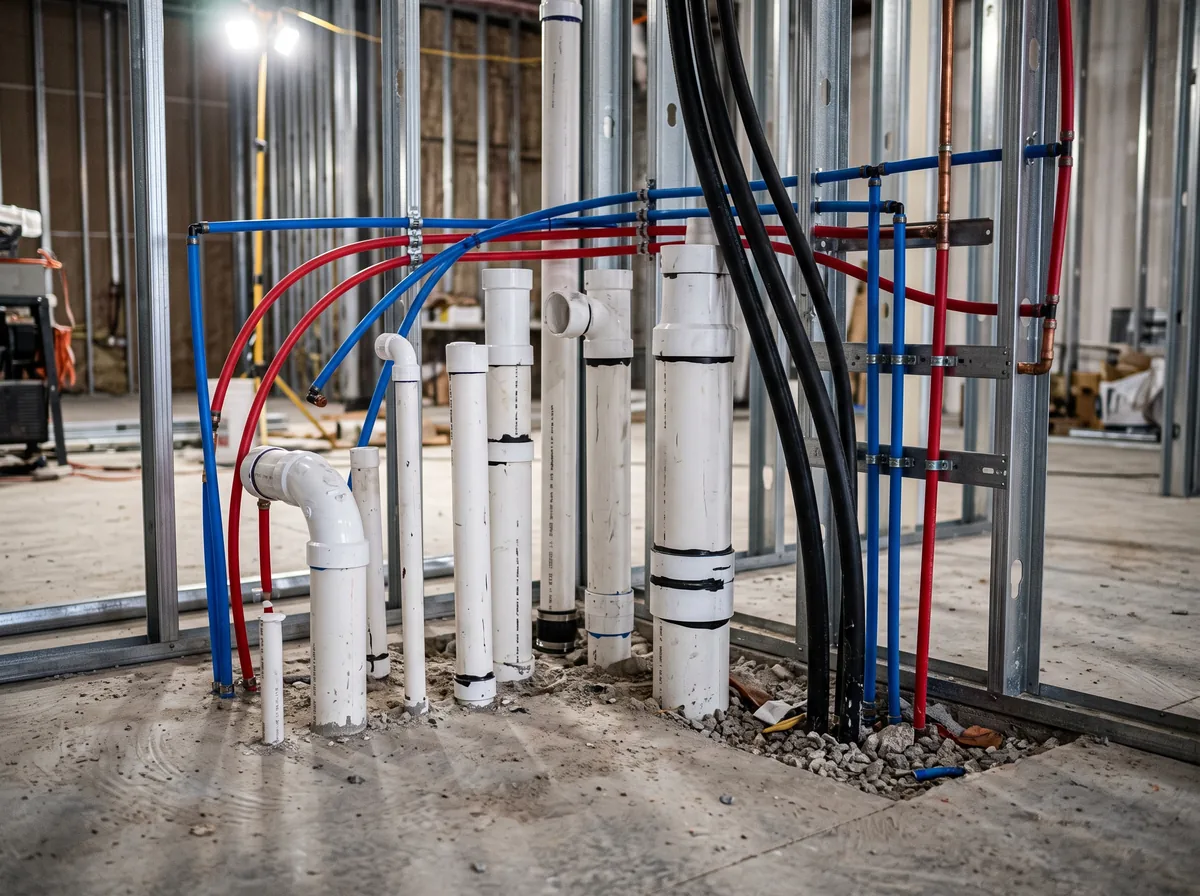

Exposed plumbing and suction rough-ins stubbed up from a concrete floor in a clinic build
Under-slab plumbing sets the layout permanently; chairs must be locked in before pouring.

The Plumbing Systems Behind Every Operatory

Dental plumbing is not house plumbing with more sinks. Each chair ties into several separate systems, and they all converge under or behind the unit.

Water, Drainage, and Suction

Clean water feeds the handpieces, the cup filler, and the sink. Waste drains to a central line, usually below the slab. Suction is the big one: a central vacuum pump pulls through lines at every chair, and an amalgam separator on the waste side captures fine particles before anything reaches the municipal sewer. That separator is not optional; it is an environmental requirement in Ontario.

Compressed Air and the Mechanical Room

A dry, oil-free medical air compressor supplies the handpieces, while the vacuum pump handles suction. Both usually sit in a dedicated mechanical room, sized for noise, heat, and service access. Undersizing that room is a classic mistake; the equipment needs airflow and clearance, not a closet.

People Often Ask: Can You Reuse the Existing Plumbing in a Leased Unit?

Sometimes the main drain and water supply can be reused, but the operatory layout almost always changes, so the branch lines and suction runs are new. In a commercial condo or plaza unit, the base building services set the limits. A good contractor confirms drain depth and available capacity before promising a layout.

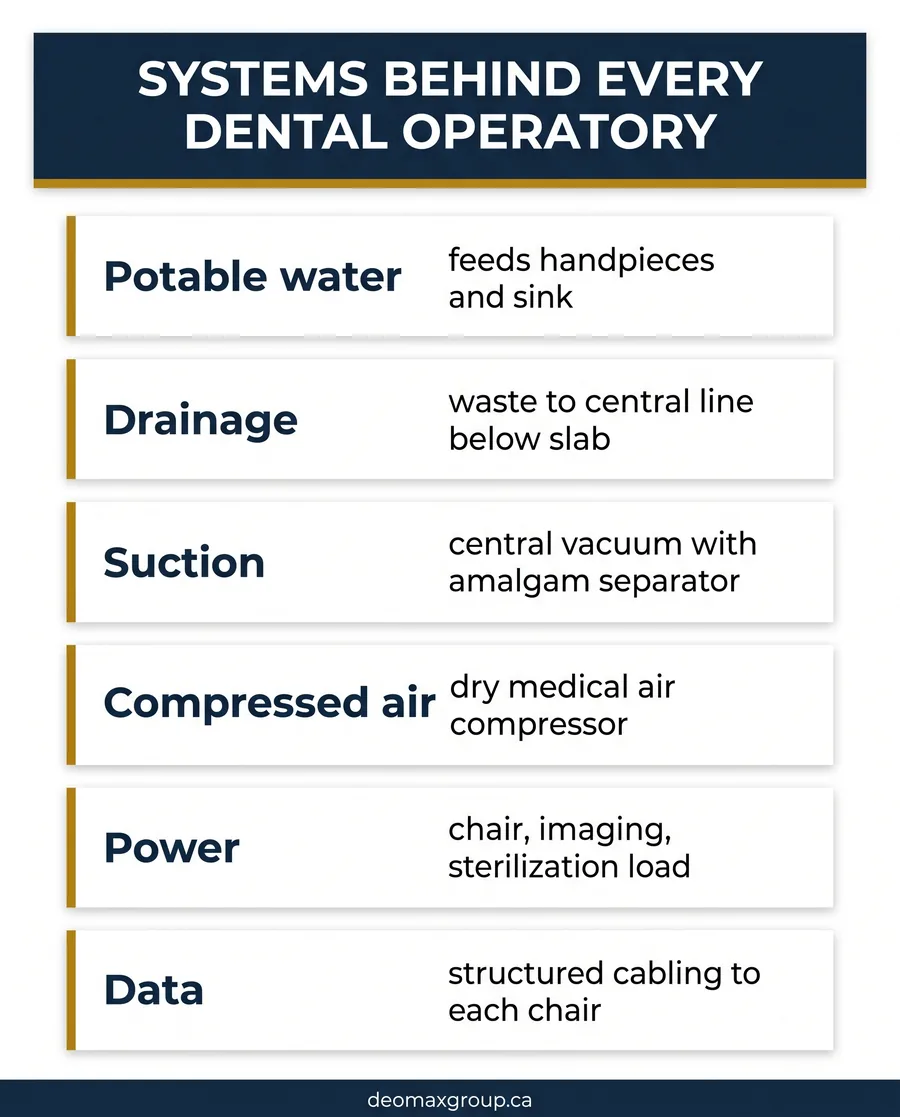

The six systems that serve every dental operatory: water, drainage, suction, air, power, and data
The dense network of mechanical and electrical systems feeding a single chair.

Power, Data, and the Electrical Load

The electrical side of a dental fit-out is heavier than most tenants expect. Each operatory carries chair power, a dental light, imaging equipment, and often a monitor and computer, and imaging in particular draws meaningful current. Add the vacuum pump, compressor, sterilization equipment, and HVAC, and many clinics need a service upgrade beyond what the base unit was built for.

All of this work has to be done by a licensed electrical contractor and inspected, like the one we recently renovated in a dental office in the GTA. In Ontario, electrical installations are regulated and inspected by the Electrical Safety Authority, and a dental clinic’s load calculation, panel, and circuiting all fall under that review.

Data and Imaging Cabling

Digital dentistry runs on the network. Every operatory needs structured cabling back to a server or rack, and the imaging systems often want dedicated runs. Pulling this cabling during rough-in, alongside the power, is far cheaper than fishing it through finished walls later.

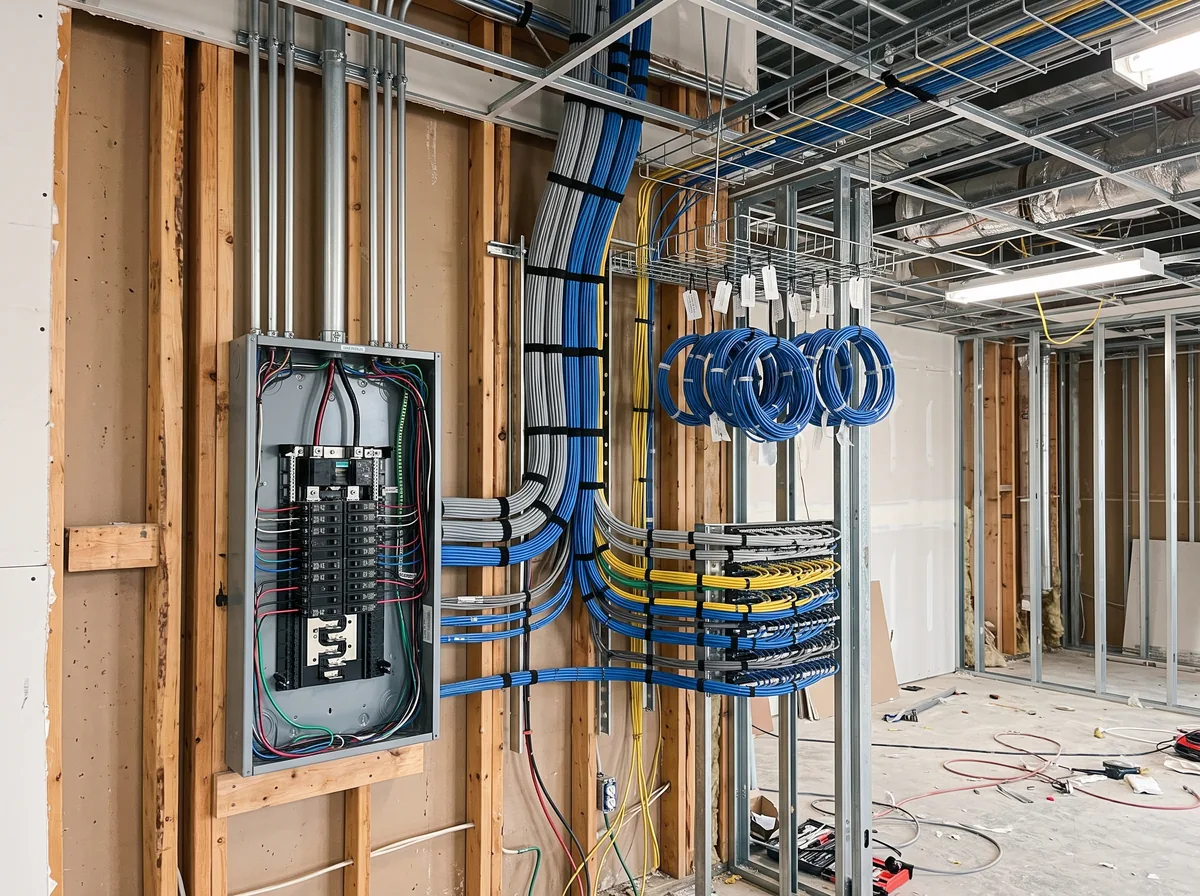

Electrical panel with conduit and network cabling roughed in on a wall in a clinic build
Organized rough-in is critical when combining high-voltage power with delicate data and imaging lines.

How the Trades Coordinate Above the Ceiling

Above the ceiling and below the slab, plumbing, suction, air, electrical, data, and HVAC ductwork all compete for the same space. On a well-run dental fit-out, the trades work from a coordinated set of drawings so nothing collides. This is where a general contractor earns their fee: sequencing the suction and drain lines under the slab first, then the overhead power and data, then ductwork, so each trade has room and no one reworks another’s job.

The same discipline applies to any technical commercial space. If your project is a larger multi-unit building, the lessons carry over to our work on commercial condo refurbishment projects, where coordination across trades keeps an occupied building running.

Did You Know?

Sterilization areas have their own dense cluster of services: hot and cold water, drainage, dedicated power for autoclaves, and ventilation. Treating the sterilization room as an afterthought is a common cause of last-minute electrical and plumbing changes late in a dental build.

Codes, Water Safety, and Inspections

A dental clinic touches several codes at once. The plumbing and structural work follows the Ontario Building Code, backflow prevention protects the municipal water supply from cross-contamination, and the electrical work answers to the Electrical Safety Authority. On top of construction codes, the clinic itself must meet the infection prevention and control standards set by the Royal College of Dental Surgeons of Ontario, which shape how water lines, sterilization, and hand hygiene stations are laid out.

Backflow prevention deserves a specific note. Because dental equipment connects to the potable supply, certified backflow preventers keep treatment water from flowing backward into the building system. Inspectors check for this, and a missing or untested device will hold up your occupancy.

People Often Ask: Does a Dental Fit-Out Need Special Permits?

Yes. Beyond the standard building permit, the plumbing, electrical, and often HVAC scopes each carry their own review and inspection. In a commercial condo, you may also need landlord and property management sign-off. Building these approvals into the schedule from the start prevents the last-minute scramble that delays openings.

Where Dental Fit-Outs Go Wrong

After enough clinic builds, the same avoidable problems show up. Watch for these:

  • Finalizing chair positions too late, forcing under-slab drain and suction lines to be re-cored.
  • Undersizing the mechanical room so the vacuum pump and compressor lack clearance and cooling.
  • Missing the electrical service upgrade until imaging and sterilization equipment overload the panel.
  • Forgetting structured data cabling during rough-in and fishing it later at higher cost.
  • Overlooking backflow prevention and amalgam separation until an inspector flags them.

None of these are exotic. They come from rushing the coordination phase. The fix is boring and reliable: lock the operatory layout early, coordinate the trades on paper, and let the rough-in lead the schedule rather than chase it.

Download the Free Quick Guide

A one-page checklist of the plumbing, electrical, and approval items to lock in before a dental build.

Download the Free Dental Fit-Out Systems Checklist (PDF)

Frequently Asked Questions

Why is plumbing so complex in a dental office renovation? +

Each operatory ties into several separate systems at once: potable water, drainage, high- and low-volume suction, and compressed air, plus an amalgam separator on the waste side. Much of it runs below the floor slab, so chair positions have to be locked in before the concrete is cut. That density, combined with the fact that changes after the slab closes mean breaking concrete, is why dental plumbing is far more involved than the plumbing in a typical office or retail fit-out.

Does a dental clinic usually need an electrical service upgrade? +

Often, yes. Imaging equipment, sterilization autoclaves, the vacuum pump, the compressor, and HVAC together draw far more than a standard tenant unit was built to supply. A licensed electrician performs a load calculation early in the design process to confirm whether the existing panel and service are adequate or need to be upsized. Catching this at the design stage is important because a late service upgrade can affect both the schedule and the budget of the whole project.

What is backflow prevention and why does it matter in a dental office? +

Backflow prevention stops water from flowing backward out of dental equipment into the building’s clean water supply, which protects against cross-contamination. Because dental handpieces and units connect to the potable system, certified backflow preventers are required and are checked at inspection. A missing or untested device will hold up occupancy. It is a small component with a big role, and it is one of the details a specialized dental fit-out contractor never leaves to chance.

Can plumbing and electrical from a previous tenant be reused? +

Sometimes the main water supply and drain can be reused, but the operatory layout almost always changes, so the branch lines, suction runs, and most circuits are new. In a leased commercial condo or plaza unit, the base building services set hard limits on drain depth and available capacity. A thorough contractor verifies those constraints before committing to a chair layout, so the design fits what the building can actually support.

How early should the mechanical and electrical design be finalized? +

As early as possible, ideally before demolition. The under-slab plumbing and suction lines, the electrical load and panel, and the data cabling all depend on the final operatory layout. Locking these decisions up front lets the trades coordinate on paper and sequence their work without collisions. Clinics that leave layout decisions open into construction almost always face costly rework, so the discipline of an early, complete design pays for itself.

Planning a new clinic or reworking an existing one? Deomax coordinates the plumbing, electrical, and mechanical scope of dental fit-outs across Mississauga, Toronto, Etobicoke, and the wider GTA, so the systems behind your walls are right the first time. Book a consultation and we will review your layout, your servicing, and the approvals your project will need before the drawings are final.

Marco R.

Written by

Marco R.

Senior General Contractor | 22 Years Experience | GTA

Marco runs the field operations for major residential builds across the GTA. With 22 years on the tools and as a project lead, he has overseen everything from basement underpinning to full home additions in Toronto, Mississauga, and Oakville. He specializes in budget control and timeline management on complex multi-trade renovations.
